Last updated 03/14/2010.
Work Schedule |
||
Calendar |
||
Sunday |
Monday |
Tuesday |
Wednesday |
Thursday |
Friday |
Saturday |
|
|
|
1 |
2 |
3 |
|
4 |
5 |
6 |
7 |
8 |
9 |
10 |
11 |
12 |
13 |
14 |
15 |
16 Contract Gallery |
17 Showroom visit |
18 |
19 |
20 |
21 Showroom electrical |
22 |
23 |
24 Showroom visit |
25 |
26 |
27 |
28 Showroom final and construction deposit |
29 |
30 |
31 |
Sunday |
Monday |
Tuesday |
Wednesday |
Thursday |
Friday |
Saturday |
1 |
2 |
3 |
4 Permits ordered (confirmation, actual order date unknown) |
5 |
6 |
7 |
8 |
9 |
10 Gallery |
11 Nonworking day |
12 Groundbreaking |

13![]() |
14 |
15 |
16 |
17 |
18 |
19 |
20 Released for Construction |
21 |
22 |
23 |
24 |
25 |
26 Thanksgiving Day Nonworking day |

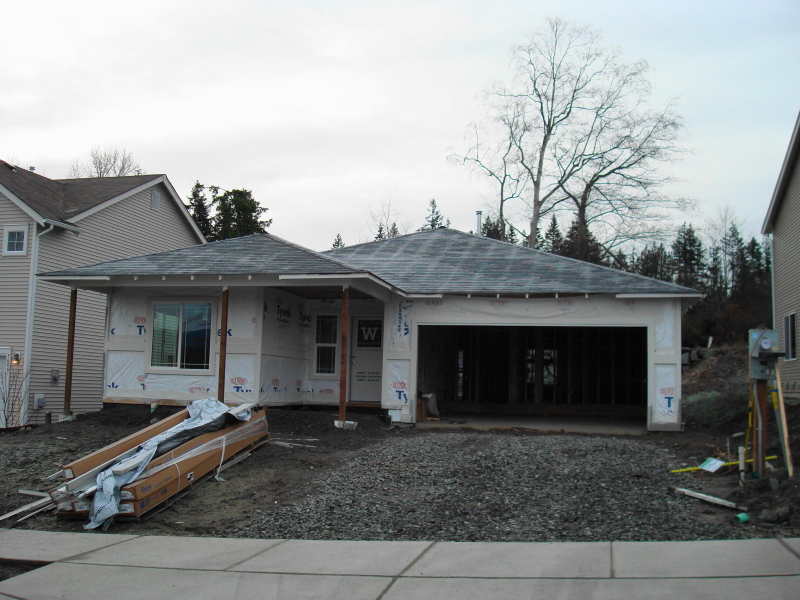

27 Nonworking day ![]() |
28 |
29 |
30 |
|
|
|
|
|
Sunday |
Monday |
Tuesday |
Wednesday |
Thursday |
Friday |
Saturday |
|
|
1 |
2 |
3 |
4![]() |
5 |
6 |
7 Day 0 Gallery |
8 Day 1 |
9 Day 2 |
10 Nonworking day (too cold!) |
11 Day 3 ![]() |
12 |
13 |
14 Day 4 |
15 Day 5 |
16 Day 6 |
17 Day 7 |
18 Day 8 ![]() |
19 Gallery |
20 |
21 Day 9 |
22 Day 10 |
23 Day 11 |
24 Christmas Eve Nonworking day |
25 Christmas Day Nonworking day |
26 |
27 |
28 Day 12 |
29 Day 13 |
30 Day 14 |
31 Day 15 ![]() |
|
|
Sunday |
Monday |
Tuesday |
Wednesday |
Thursday |
Friday |
Saturday |
|
|
|
|
1 New Year's Day Nonworking day |
2 |
|
3 |
4 Day 16 |
5 Day 17 |
6 Day 18 |
7 Day 19 |
8 Day 20 Gallery ![]() |
9 |
10 |
11 Day 21 |
12 Day 22 |
13 Nonworking day (windy and rainy) |
14 Day 23 ![]() |
15 Day 24 |
16 |
17 |
18 Nonworking day |
19 Day 25 |
20 Day 26 |
21 Day 27 ![]() |
22 Day 28 |
23 |
24 |
25 Day 29 |
26 Day 30 |
27 Day 31 |
28 Day 32 ![]() |
29 Day 33 |
30 Gallery |
31 |
|
|
|
|
|
|
Sunday |
Monday |
Tuesday |
Wednesday |
Thursday |
Friday |
Saturday |
1 |
1 Day 34 |
2 Day 35 |
3 Day 36 |
4 Day 37 ![]() |
5 Day 38 |
6 |
7 |
8 Day 39 |
9 Day 40 |
10 Day 41 |
11 Day 42 Gallery |
12 Day 43 |
13 |
14 |
15 Nonworking day |
16 Day 44 |
17 Day 45 |
18 Day 46 ![]() |
19 Day 47 Gallery Home Inspection - Pillar to Post |
20 |
21 |
22 Day 48 |
23 Day 49 |
24 Day 50 |
25 Day 51 Gallery |
26 Day 52 Gallery |
27 |
28 |
|
|
|
|
|
|
Sunday |
Monday |
Tuesday |
Wednesday |
Thursday |
Friday |
Saturday |
|
1 Day 53 Escrow / signing |
2 Day 54 Gallery |
3 Gallery Delivery and installation: Glass shower door Delivery and hook up: Refrigerator, Freezer, Washer, Dryer Carpenter: Elfa installation Meridien Center Electric: Outlet in hub |
4 Movers deliver |
5 |
6 |
7 DirecTV installation |
8 Verizon installation |
9 |
10 |
11 |
12 |
13 |
14 |
15 |
16 |
17 |
18 |
19 |
20 |
21 |
22 |
23 |
24 |
25 |
26 |
27 |
28 |
29 |
30 |
31 |
|
|
|
Date |
Escort |
Work Day |
Activity |
---|---|---|---|
12/07/09 |
Orientation |
Homesite Orientation |
|
12/08/09 |
Drop lumber / 1st floor joists |
||
12/09/09 |
Underfloor inspection / garage walls |
||
12/11/09 |
Sheeting 1st floor / start 1st floor walls |
||
12/14/09 |
Finish 1st floor walls |
||
12/15/09 |
2nd floor joists / sheet 2nd floor |
||
12/16/09 |
Stairs / start 2nd floor walls |
||
12/17/09 |
Finish 2nd floor walls / deliver & start roll trusses |
||
12/18/09 |
Finish roll trusses / start roof sheet / deliver windows |
||
12/21/09 |
Finish roof sheet |
||
12/22/09 |
Install windows |
||
12/23/09 |
Start plumbing rough / stock roof |
||
12/28/09 |
Finish plumbing rough / lay roof / fire sprinklers |
||
12/29/09 |
Finish roof / start heat rough / fireplace install / prerock / drop siding / entry door |
||
12/30/09 |
Finish heat rough / wrap & wood trim |
||
12/31/09 |
Start electric rough / start siding / brick or stone / paint trim / gas piping |
||
01/04/10 |
Finish electric rough / siding / inspection |
||
01/05/10 |
Siding / inspection / polyseal |
||
01/06/10 |
Siding / inspection |
||
01/07/10 |
Siding / inspection |
||
01/08/10 |
Frame walk |
Siding / inspection |
|
01/11/10 |
Finish siding / install batts |
||
01/12/10 |
Installation inspection / stock rock / paint siding |
||
01/14/10 |
Hang rock / gutters |
||
01/15/10 |
Hang rock / call inspection |
||
01/19/10 |
Hang & scrap / nailing inspection / PU |
||
01/20/10 |
Drywall inspection / tape / garage door install |
||
01/21/10 |
Tape |
||
01/22/10 |
Tape |
||
01/25/10 |
PVA |
||
01/26/10 |
Texture |
||
01/27/10 |
Paint walls / millwork |
||
01/28/10 |
Fireplace / electrical trim |
||
01/29/10 |
Cabinet / install underlayment & millwork |
||
02/01/10 |
Complete millwork |
||
02/02/10 |
Install cabs / blow in insulation |
||
02/03/10 |
Install vinyl / p-lam / blow in insulation |
||
02/04/10 |
Install tile / start hardwood |
||
02/05/10 |
Grout tile / finish hardwood / prep millwork |
||
02/08/10 |
Complete millwork / paint prep / countertops |
||
02/09/10 |
Paint millwork |
||
02/10/10 |
Paint millwork / irrigation |
||
02/11/10 |
Plumb trim / electric trim / fp lite / mirrors and shelves / sprnklr trim |
||
02/12/10 |
Preclean / deliver appliances |
||
02/16/10 |
Carpet |
||
02/17/10 |
Carpet |
||
02/18/10 |
Heat trim / hardware / handrails / drywall punch |
||
02/19/10 |
Final clean / deliver prep |
||
02/22/10 |
Blinds / window clean / delivery prep / C.O. inspection |
||
02/23/10 |
Paint punch / delivery prep / C.O. inspection |
||
02/24/10 |
Paint punch / landscape |
||
02/25/10 |
Install screens / touchup cln |
||
02/26/10 |
Orientation / corrections |
||
03/01/10 |
Escrow / corrections |
||
03/02/10 |
Orientation acceptable / closing / occupancy |
